Harehill Energy Park

Introduction

Renewco Power, together with development partner Locogen, has secured planning permission for Harehill Energy Park, a solar and battery energy storage project near Shotton Colliery, County Durham. The project comprises up to 31.5 MW of Solar PV and a 10.35 MW Battery Energy Storage System (BESS). Planning permission was granted following a successful planning appeal in July 2026.

Location

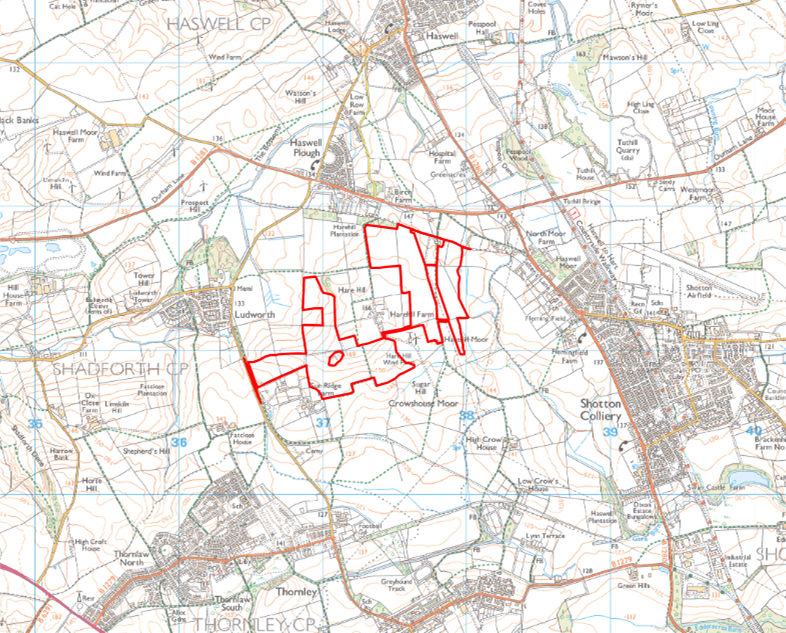

Harehill Energy Park is located at Harehill Farm, near Shotton Colliery in County Durham. The site lies to the south of the B1283, approximately  9km east of Durham, and comprises agricultural land surrounding Harehill Farm. The consented development comprises a solar photovoltaic (PV) array and associated battery energy storage system (BESS).

Our Proposal

Harehill Energy Park comprises a solar photovoltaic (PV) development alongside a Battery Energy Storage System (BESS) and associated infrastructure. The consented development includes:

•up to 31.5 MW of solar generation;
•a 10.35 MW Battery Energy Storage System (BESS);
•associated electrical infrastructure;
•site access and internal access tracks; and
•landscaping, biodiversity enhancement and environmental mitigation measures.

Why is this project needed?

The UK is transitioning towards a cleaner, more secure energy system, requiring significant additional renewable  electricity generation and energy storage capacity.

Harehill Energy Park will contribute to this transition by generating renewable electricity from solar energy, while the battery energy storage system will provide flexibility by storing electricity and releasing it when it is needed.

By delivering additional renewable generation and energy storage capacity, Harehill Energy Park will contribute towards the UK Government’s Net Zero targets, while helping to reduce reliance on fossil fuels and supporting the decarbonisation of the electricity system.

Planning Permission

The UK is transitioning towards a cleaner, more secure energy system, requiring significant additional renewable  electricity generation and energy storage capacity.

Harehill Energy Park will contribute to this transition by generating renewable electricity from solar energy, while the battery energy storage system will provide flexibility by storing electricity and releasing it when it is needed.

By delivering additional renewable generation and energy storage capacity, Harehill Energy Park will contribute towards the UK Government’s Net Zero targets, while helping to reduce reliance on fossil fuels and supporting the decarbonisation of the electricity system.

Harehill Energy Park Planning Appeal Decision, 24 July 2026

Grid Connection

Harehill Energy Park has secured Gate 2 Phase 2 status under the reformed electricity connection process. The project also has a Technical Limits connection opportunity from Q4 2029, allowing the project to connect ahead of completion of the wider transmission reinforcement works, subject to the final connection arrangements. Grid connection and operation are therefore currently anticipated in Q4 2029.

Indicative Development Timescale

Q1 2021

Site Selection

2023-2024

Preliminary Assessments Site Design and Public Engagement

December 2024

Planning Application submitted

July 2025

Planning Application refused

June 2026

Planning Appeal hearing

July 2026

Planning permission granted following successful appeal

Late 2026

Detailed Gate 2 connection offer expected

2027 - early 2029

Detailed design, discharge of planning conditions and pre-construction activities

Q1 2029

Anticipated start of construction

Q4 2029

Anticipated grid connection and operation

2070

Decommissioning

Downloads

Please find our downloads below but note that further planning documents are available through Durham County Council’s online planning register using application reference DM/24/03473/FPA.

Get in touch

We are interested in engaging with wind and solar asset owners, land-owners, developers and funders.

Cookie policy

Learn more about how we use cookies on our website to improve your experience.
